Solar (PV) Power Plant Project Gantt Schedule Template   Excel template (XLSX)
$49.00

Solar (PV) Power Plant Project Gantt Schedule Template (Excel template (XLSX)) Preview Image
Solar (PV) Power Plant Project Gantt Schedule Template (Excel template (XLSX)) Preview Image
Solar (PV) Power Plant Project Gantt Schedule Template (Excel template (XLSX)) Preview Image
Solar (PV) Power Plant Project Gantt Schedule Template (Excel template (XLSX)) Preview Image
Solar (PV) Power Plant Project Gantt Schedule Template (Excel template (XLSX)) Preview Image
Flevy is the marketplace for business best practices.
Solar (PV) Power Plant Project Gantt Schedule Template (Excel template (XLSX)) Preview Image
Solar (PV) Power Plant Project Gantt Schedule Template (Excel template (XLSX)) Preview Image
Solar (PV) Power Plant Project Gantt Schedule Template (Excel template (XLSX)) Preview Image
Solar (PV) Power Plant Project Gantt Schedule Template (Excel template (XLSX)) Preview Image
Solar (PV) Power Plant Project Gantt Schedule Template (Excel template (XLSX)) Preview Image
Arrow   Click main image to view in full screen.

Solar (PV) Power Plant Project Gantt Schedule Template – Excel XLSX

Excel (XLSX)

$49.00
This toolkit is created by trained McKinsey, BCG, and Porsche Consulting consultants and is the same used by MBB, Big 4, and Fortune 100 companies when …
Add to Cart



Immediate download
Fully editable Excel
Free lifetime updates

BENEFITS OF THIS DOWNLOADABLE EXCEL DOCUMENT

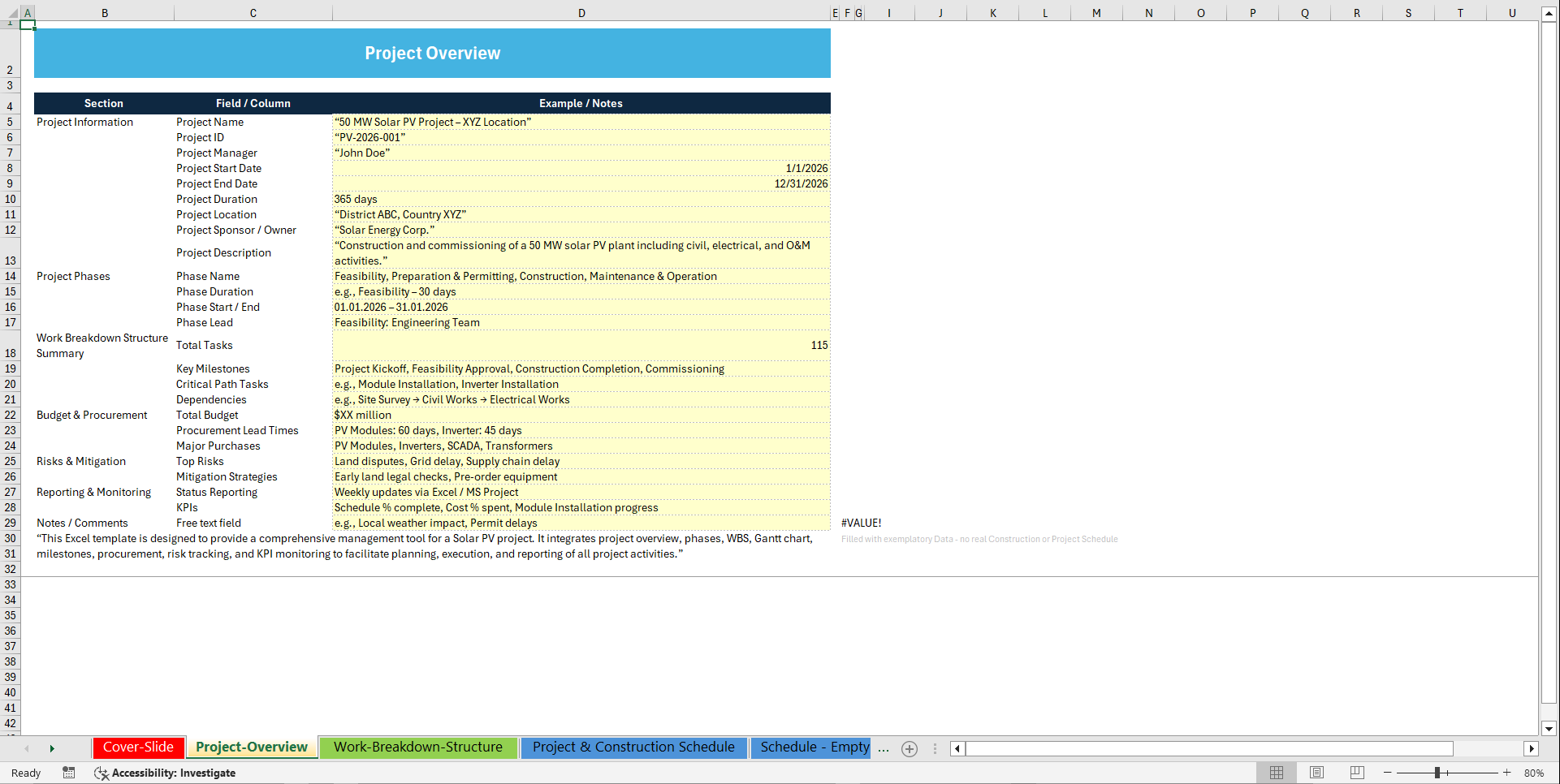

  1. Provides a complete, fully automated framework for planning and managing every phase of a Solar (PV) Power Plant project.
  2. Delivers a structured, detail-rich project schedule that streamlines feasibility, permitting, procurement, construction, and commissioning activities.
  3. Enables teams to execute solar projects with clarity, accuracy, and predictable timelines using a comprehensive, industry-standard Gantt schedule.

SOLAR ENERGY EXCEL DESCRIPTION

Solar PV Power Plant Gantt Template (Excel) — Download a fully automated Gantt + WBS for utility-scale solar projects: permits, procurement, construction, commissioning. Solar (PV) Power Plant Project Gantt Schedule Template is an Excel template (XLSX) available for immediate download upon purchase.

Curated by McKinsey-trained Executives


🚀 Solar (PV) Power Plant Project Gantt Schedule Template (Excel) – The Ultimate Automated Project Planning Tool for Utility-Scale Solar Projects

If you're planning, managing, or delivering a Solar (PV) Power Plant Project, you already know the biggest challenge isn't the engineering—
it's coordinating hundreds of tasks, permits, procurement cycles, construction milestones, and commissioning activities without missing a beat.

Introducing the Solar (PV) Power Plant Project Gantt Schedule Template (Excel) – the most complete, fully-automated, professionally structured PV project scheduler designed for developers, EPC firms, consultants, project managers, O&M teams, and utility-scale solar investors.

This aggressively optimized and highly structured Excel template is your end-to-end project planning powerhouse, featuring:

•  ✔️ A *fully automated Gantt timeline*
•  ✔️ A complete Work Breakdown Structure (WBS) with 100+ expertly defined tasks
•  ✔️ Smart formulas auto-calculating dates, durations, dependencies, and critical paths
•  ✔️ Clean dashboards for executive reporting
•  ✔️ Complete lifecycle coverage: Feasibility → Permitting → Construction → Commissioning → O&M

No more messy spreadsheets.
No more scheduling chaos.
Just clarity, accuracy, and total project control.


🌞 Why This Solar Power Plant Gantt Template Is the Industry's #1 Scheduling Tool

This template is built for real-world solar deployment—whether you're delivering a 1 MW distributed rooftop site or a 200 MW utility-scale plant.

It includes every phase, every task, every dependency, backed by industry-standard methodology.

🔥 Key Features:
1. Fully Automated Gantt Chart for Solar Power Plants
Just set your Project Start Date and the entire Gantt schedule updates automatically—
covering feasibility, engineering, permitting, procurement, construction, electrical integration, testing, and O&M preparation.

2. Complete Project Information Dashboard
Perfect for PMOs, EPC teams, consultants, and investor reporting:
•  Project Name
•  Project ID
•  Project Manager
•  Start/End Dates
•  Duration
•  Location
•  Sponsor / Owner
•  Executive Summary

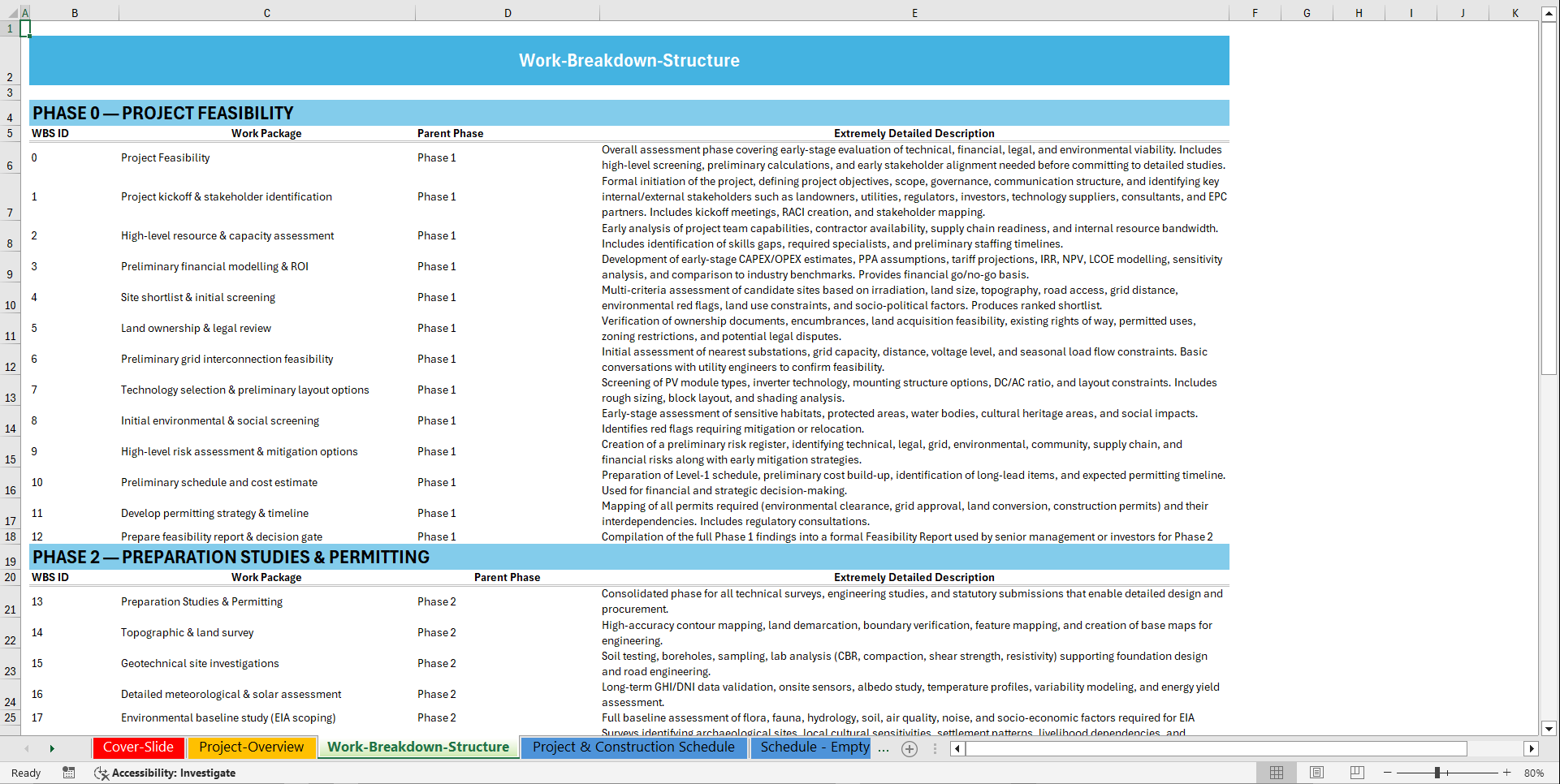

3. Complete Solar PV Work Breakdown Structure (WBS)
Includes more than 115 detailed tasks, broken down into four structured phases:
•  Phase 1: Project Feasibility
•  Phase 2: Preparation Studies & Permitting
•  Phase 3: Construction & Electrical Installation
•  Phase 4: Maintenance & Operation

4. Budget, Procurement & Long-Lead Management
Track:
•  Total Project Budget
•  Major Purchases
•  Lead Times
•  Procurement Dependencies
•  PO Cycles
•  Delivery Risks

5. Permitting, EIA, Grid Approval & Engineering Study Schedule
Every crucial step is included—environmental baseline studies, grid impact studies, geotechnical testing, SLD preparation, tender documents, and more.

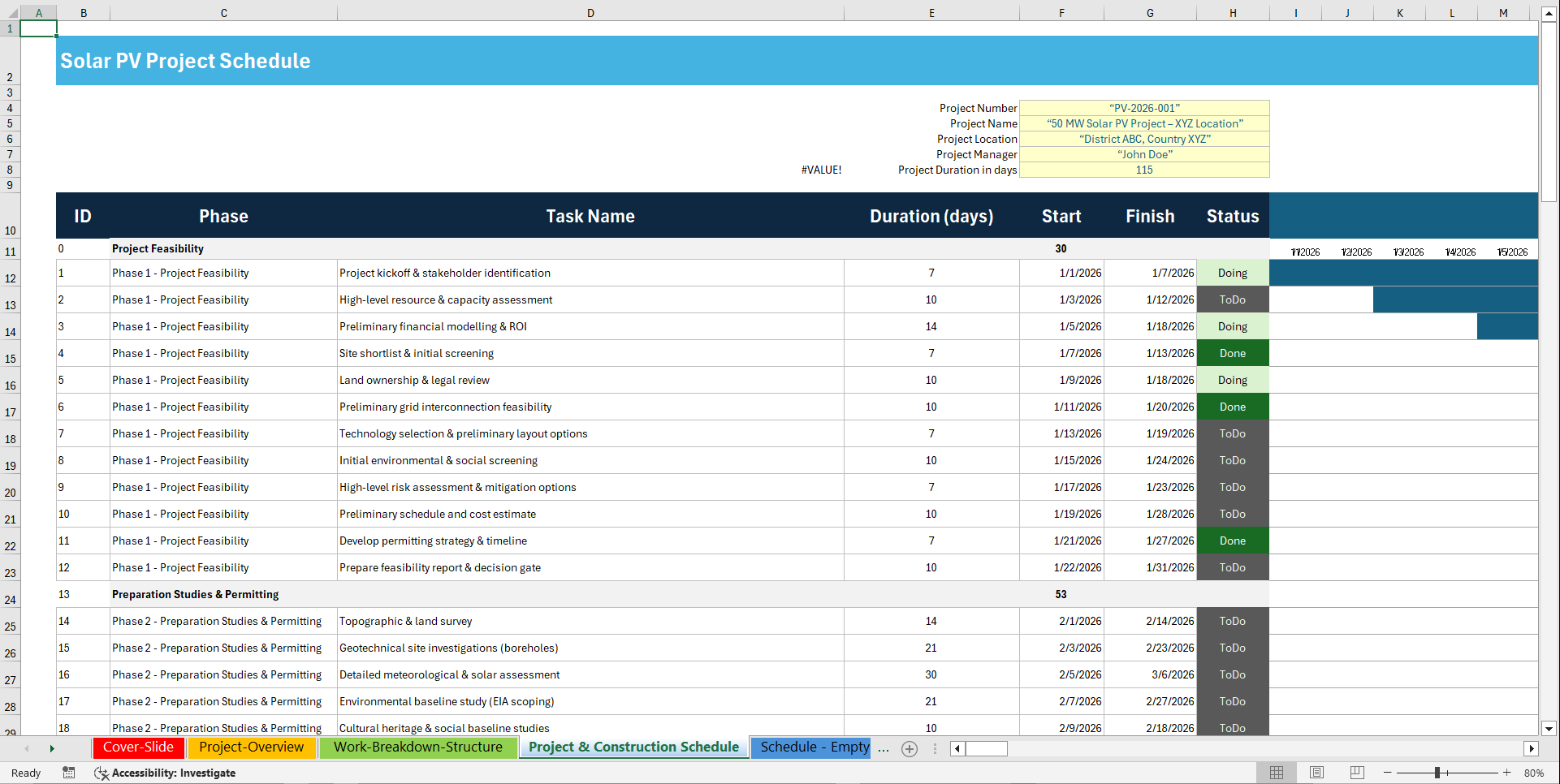

6. Construction Gantt Timeline for Solar Power Plants
Covering detailed civil, mechanical, electrical, and SCADA works—
including foundations, MMS, cables, inverters, modules, OFC, CCTV, lightning arrestors, testing, and commissioning.

7. O&M Handover & Performance Monitoring Scheduler
Includes post-COD tasks such as:
•  PR evaluation
•  Warranty tracking
•  Spare parts logistics
•  SLA monitoring
•  Preventive maintenance planning

🌟 What Makes This Template Unmatched in the Solar Industry?
It includes every task a real solar EPC team needs, including highly specialized activities like:

✔️ *Topographic survey*
✔️ *Hydrology & drainage modeling*
✔️ *Grid impact & protection study*
✔️ *DC cable termination*
✔️ *SCADA integration & field signal testing*
✔️ *Environmental & cultural heritage screening*
✔️ *Pre-commissioning & synchronization tests*
✔️ *O&M readiness & handover documentation*

This is not a generic project template—
it's a complete solar project execution model, built for professionals who need accuracy, structure, and predictable delivery timelines.


⚡ Who Is This Solar Project Gantt Template For?

This template is ideal for:
•  EPC Contractors
•  Solar Developers
•  Engineering Consultancies
•  Project Managers
•  Utility Providers
•  Investors & IPPs
•  Government Agencies
•  O&M Service Providers
•  Renewable Energy Advisors
•  Feasibility Teams

If you manage *any part* of the solar development lifecycle, this tool will cut hours of planning, eliminate schedule delays, and prevent overlooked tasks.

Highlights
🔹 Shorter project timelines
🔹 Better cost and procurement visibility
🔹 On-time permitting & approvals
🔹 Zero missing tasks or forgotten deliverables
🔹 Accurate reporting to clients & management
🔹 Streamlined EPC communications
🔹 Automated schedule adjustments with no manual errors
🔹 Faster commissioning & energization

🎯 Included Sections in the Solar Gantt Template
Project Information Module
Project Name • ID • Manager • Location • Duration • Sponsor • Description

Phase-Based Gantt Timeline
Feasibility → Studies → Permitting → Construction → O&M



🚀 Dominate Your Solar Projects with the Most Advanced Scheduling Tool

Deliver your solar (PV) projects on time, on budget, and with full control using this sophisticated, automated, and industry-proven Excel Gantt schedule.

Whether you're pitching investors, planning EPC execution, or managing multi-phase solar construction—
this template gives you the structure and intelligence to succeed.


👉 Get the Solar (PV) Power Plant Project Gantt Schedule Template Today

Unlock total project clarity, eliminate delays, and streamline your entire solar development lifecycle.

The renewable energy industry runs on precision.
With this template, you'll project confidence, control, and competence from day one.





Key Words:
Strategy & Transformation, Growth Strategy, Strategic Planning, Strategy Frameworks, Innovation Management, Pricing Strategy, Core Competencies, Strategy Development, Business Transformation, Marketing Plan Development, Product Strategy, Breakout Strategy, Competitive Advantage, Mission, Vision, Values, Strategy Deployment & Execution, Innovation, Vision Statement, Core Competencies Analysis, Corporate Strategy, Product Launch Strategy, BMI, Blue Ocean Strategy, Breakthrough Strategy, Business Model Innovation, Business Strategy Example, Corporate Transformation, Critical Success Factors, Customer Segmentation, Customer Value Proposition, Distinctive Capabilities, Enterprise Performance Management, KPI, Key Performance Indicators, Market Analysis, Market Entry Example, Market Entry Plan, Market Intelligence, Market Research, Market Segmentation, Market Sizing, Marketing, Michael Porter's Value Chain, Organizational Transformation, Performance Management, Performance Measurement, Platform Strategy, Product Go-to-Market Strategy, Reorganization, Restructuring, SWOT, SWOT Analysis, Service 4.0, Service Strategy, Service Transformation, Strategic Analysis, Strategic Plan Example, Strategy Deployment, Strategy Execution, Strategy Frameworks Compilation, Strategy Methodologies, Strategy Report Example, Value Chain, Value Chain Analysis, Value Innovation, Value Proposition, Vision Statement, Corporate Strategy, Business Development, Busienss plan pdf, business plan, PDF, Biusiness Plan DOC, Bisiness Plan Template, PPT, Market strategy playbook, strategic market planning, competitive analysis tools, market segmentation frameworks, growth strategy templates, product positioning strategy, market execution toolkit, strategic alignment playbook, KPI and OKR frameworks, business growth strategy guide, cross-functional strategy templates, market risk management, market strategy PowerPoint dec, guide, ebook, e-book ,McKinsey Change Playbook, Organizational change management toolkit, Change management frameworks 2025, Influence model for change, Change leadership strategies, Behavioral change in organizations, Change management PowerPoint templates, Transformational leadership in change, supply chain KPIs, supply chain KPI toolkit, supply chain PowerPoint template, logistics KPIs, procurement KPIs, inventory management KPIs, supply chain performance metrics, manufacturing KPIs, supply chain dashboard, supply chain strategy KPIs, reverse logistics KPIs, sustainability KPIs in supply chain, financial supply chain KPIs, warehouse KPIs, digital supply chain KPIs, 1200 KPIs, supply chain scorecard, KPI examples, supply chain templates, Corporate Finance SOPs, Finance SOP Excel Template, CFO Toolkit, Finance Department Procedures, Financial Planning SOPs, Treasury SOPs, Accounts Payable SOPs, Accounts Receivable SOPs, General Ledger SOPs, Accounting Policies Template, Internal Controls SOPs, Finance Process Standardization, Finance Operating Procedures, Finance Department Excel Template, FP&A Process Documentation, Corporate Finance Template, Finance SOP Toolkit, CFO Process Templates, Accounting SOP Package, Tax Compliance SOPs, Financial Risk Management Procedures.


NOTE: Our digital products are sold on an "as is" basis, making returns and refunds unavailable post-download. Please preview and inquire before purchasing. Please contact us before purchasing if you have any questions! This policy aligns with the standard Flevy Terms of Usage.

Got a question about the product? Email us at support@flevy.com or ask the author directly by using the "Ask the Author a Question" form. If you cannot view the preview above this document description, go here to view the large preview instead.

Source: Best Practices in Solar Energy Excel: Solar (PV) Power Plant Project Gantt Schedule Template Excel (XLSX) Spreadsheet, SB Consulting
